Steering Meeting #02

Date

Steerco - Valio Aimo

Introductions

Project Objectives

Valio aims to standardise the Quote to Order process and streamline it it via the existing Pricing AND ERP systems by:

  • Reducing manual processes

  • Improve ways of working

  • Enablement of Sales and Operational teams

  • Improve data quality

  • Increased management of agreements

Deliverables and Success Criteria

Deliverables

  • Functioning CPQ solution - providing an end to end process, starting from SAP S4 Hana aligned with the business model

  • Production of supporting documentation of the system build during the project lifecycle

  • User manual guides on how the end users can utilise the system to the best of their abilities

Success Criteria

  • Users are able to generate accurate quotes in an automatous way

  • Seamless data flow across all systems

  • Positive feedback from UAT testing sessions

  • Stakeholder signoff on all deliverables

Where are we to date…

Sprint Planning has commenced and resulted in User Stories being assigned to a Sprint review. This provides us with the opportunity to build the story of how the application will be utilised. During the Sprint review sessions you will have the opportunity to review what’s been built and how the functionality ties together.

Review of Sprint 1

User Stories Status

Sprint 1 - User Stories

To Do

In Progress

Done

Pending

26

9

2

12

3

Open Points

Open Points - list of outstanding questions where we need clarification

Open Points

To Do

In Progress

Done

17

2

3

12

Sub Tasks

Sub Tasks - associated to user stories where items need to be completed for Sprint

User Stories

Open Points

Sub Tasks

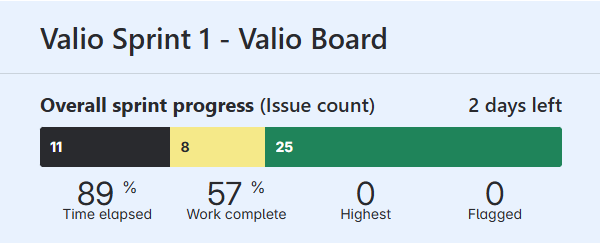

% Complete

What’s Left

26

17

96

56%

53

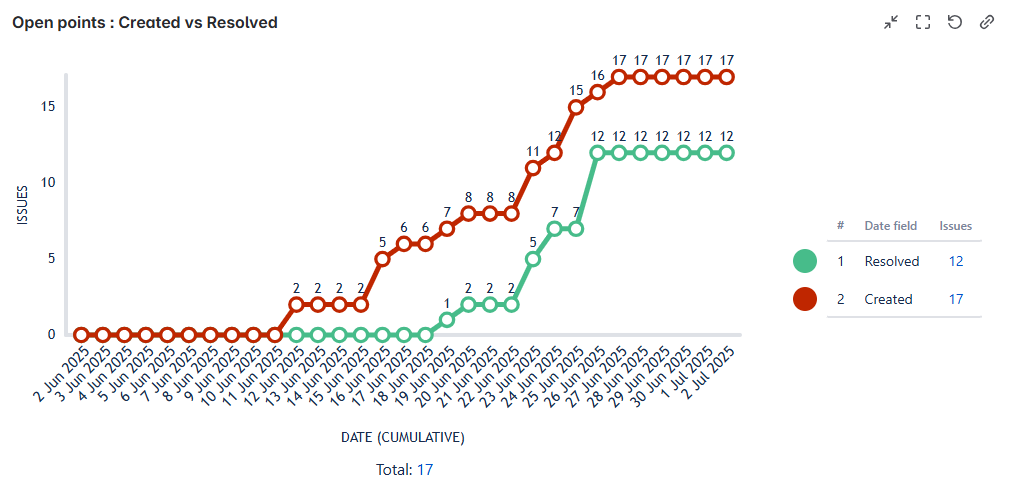

Open points

Currently we have 5 Open points.

Timeline & Milestones

Project Status

What does this all mean…

  • Open point are still to be clarified. We are making progress on those that are clarified

  • Environment issues occurred which affected our progress, they are resolved now

  • Not all User Stories for Sprint 1 will be ready for the sprint review due the above reason

  • The SCD has yet to be signed off, this details the design of the system and provides understanding on the design of the application fit with the business

  • Project budget is on target thus far and currently we don't foresee any changes

  • Once Sprint 1 review is complete we will go through Sprint 2 planning and produce a plan to support any user stories from the previous sprint which were not completed

  • For Sprint 1, we will focus on wrapping up the current tasks with the information we have.

  • We'll make trade-offs where possible to ensure we achieve the best progress for this sprint.

  • Any user stories that require additional information will be moved to Sprint 3, when we can discuss them with the project team

  • Sprint 2 will still start on

  • We will select user stories that we can work on autonomously

  • We will share this list with you during the Sprint 1 review

  • We're committed to aligning our efforts with the availability of the Valio project team

  • This might mean we'll need to adjust the team's workload if we're unable to make progress on certain topics

Overall project status

🟢

Open Discussion / Q & A

Wrap-Up & Next Steps
