Weekly Meeting #31
Date |
|
|---|
1. Participants & Attendance
Name | Company | Role |
|---|---|---|
Emmi Kaipia | Valio | Head of Business Development |
Teemu Salonen | Valio | Pricing Analyst |
Tomi Toivonen | Valio | Pricing Manager |
Omar Bendada | Ben Consulting Services | Business Analyst |
Peter Jarvis | Ben Consulting Services | Project Manager |
2. Progress Summary
Three principal outstanding issues to resolve to deliver an MVP for Soft Go-Live
BCS to implement margin calculations and summary page
Zilliant to resolve three outstanding bugs
Zilliant, supported by BCS, to get the performance of CPQ to an acceptable level
Margin calculations are in progress and targeting
Sessions with Tomi & Teemu yesterday and today to clarify requirements
We expect to have this ready for 23rd Jan date provided that no new requirements appear
CPQ product bugs are estimated to be fixed by 20th Jan
Scripts to update CPQ from Price Manager not running automatically
Date discrepancies on agreement creation, guidance retrieval and publish
Cannot copy net priced items from another deal
Performance to be addressed by 23rd Jan
Some improvements made already, but still not acceptable
Scripts being reviewed by Zilliant technical teams to find optimisation opportunities

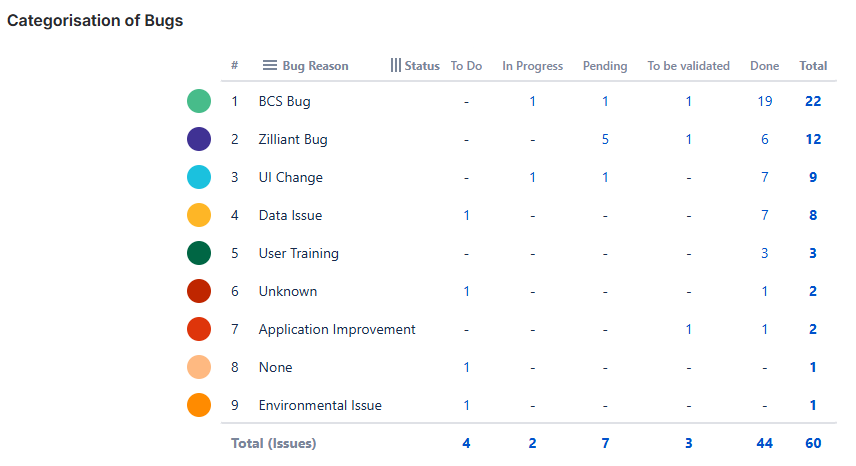

Some other bugs remain, but the above lists the main headings to be addressed by 23rd Jan
3. State of Readiness for Soft Go-Live
Margin Calculations and Summary Page
Requirements further clarified at workshops yesterday and today
Mohamed is now implementing, and expects to be done by
This feature will require extensive testing which is unlikely to complete by 23rd Jan: need to decide whether we can proceed to a Soft Go-Live with a beta version
Bugs With Zilliant for Resolution

Ref | Description | Status | Delivery Date |
|---|---|---|---|
VAL-598 | Valio guidance is giving wrong numbers | Issue fixed but update script will not run on automated schedule; Zilliant has provided a solution to implement | 16th Jan |
VAL-644 | New net price from PM to CPQ (net price process) | Issue fixed but same automation issue as 589 above | 16th Jan |
VAL-607 | CPQ and PM dates not in sync | ||
VAL-740 | Deal start and end date | With Valio to test | 16th Jan |
VAL-716 | Can’t set prices on lines screen | ||
VAL-749 | Can’t copy net priced items from another deal | With Zilliant Engineering | 20th Jan |
Performance
The principal issue is that it was taking 10-15 minutes to add a Product Group. We have implemented some suggestions from Zilliant into the relevant scripts and this has reduced to 3 minutes or less. However, Save now takes 7 minutes. We have shared our scripts with Zilliant and their technical teams are reviewing to identify opportunities for optimisation
Completion of MVP for Soft Go-Live
If there are no further changes required, BCS expects to have the MVP ready, though not yet fully tested, by 23rd Jan.
Performance remains a significant risk, and we are working closely with Zilliant to get it to an acceptable level.

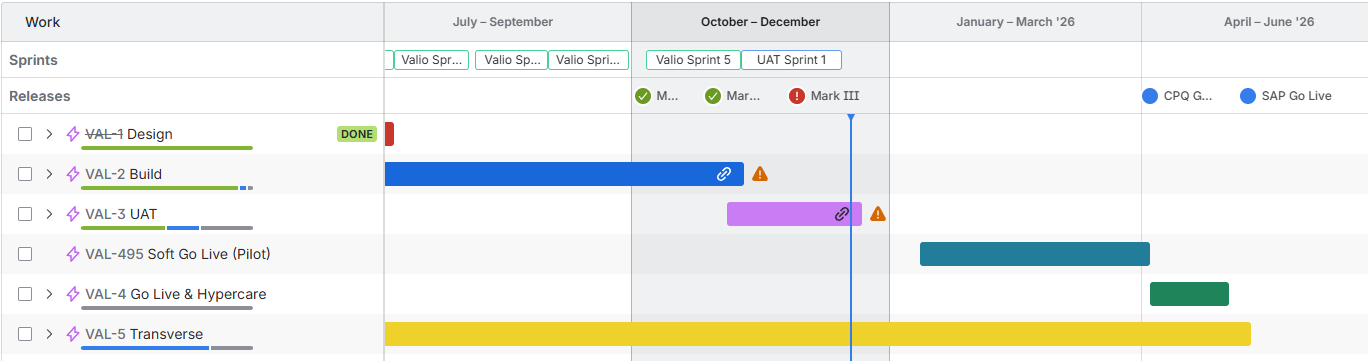

4. Project Timeline
